Prepare Training

Nationally recognised building and construction qualifications delivered 100% online.

RTO 45384

Qualifications

BuildingCertificate IV in BuildingCertificate IV NSW/WADiploma of BuildingDiploma of Building NSW/WAAdvanced DiplomaWork Health & SafetyCertificate IV in WHSDiploma of WHSProject SupportEstimatorContract AdministratorSupervisionLow-Rise Site SupervisorOpen Class Site SupervisorView All Courses

Resources

BlogLicence GuidesTools & CalculatorsRecognition of Prior LearningCourse ComparisonStudent HandbookFAQs

Get in Touch

1300 142 181hello@prepare.com.au
15/1 Newspaper Pl
Maroochydore QLD 4558
Enquire Now

© 2026 Prepare Training. RTO 45384. All rights reserved.

Privacy PolicyStudent HandbookTerms of Service
Australian site supervisor reviewing a printed safe work method statement on a clipboard at the base of scaffolding before high risk construction work starts
Site Safety & WHS

How to write a SWMS, step by step

A current-to-2026, state-aware guide to writing a site-specific Safe Work Method Statement for high risk construction work, with seven steps that mirror our free draft generator.

Last updated 4 Jul 2026

  1. Home
  2. Blog
  3. How to Write a SWMS
37
Construction deaths in 2024 (20% of all worker deaths)
~45%
Of falls-from-height worker deaths are construction
506
Notices in one 2025 SafeWork NSW blitz
$3.74m
WorkSafe Vic height fines, 52 employers, 2025

Key takeaways

  • A SWMS is legally required only for high risk construction work. Regulation 291 of the model WHS Regulations lists 18 categories, and Victoria lists 19 under its own OHS Regulations 2017.
  • Under regulation 299(2) a SWMS must do four things: identify the high risk work, state the hazards and risks, describe the control measures, and describe how those controls are implemented, monitored and reviewed.
  • From 1 July 2026, South Australia lowered its fall trigger from 3 metres to 2 metres, so 2 metres is now the SWMS fall-height trigger in every Australian jurisdiction.
  • Controls must be listed in hierarchy-of-controls order: eliminate the hazard first (regulation 35), then substitution, isolation and engineering controls, then administrative controls, with PPE last (regulation 36).
  • A generic, non-site-specific SWMS is the failure regulators flag most often. Prepare Training’s free SWMS generator gives you a draft starting point you make site-specific and consult your workers on, not a finished document.
When do you legally need a SWMS?What a SWMS must includeHow to write a SWMS in seven stepsThe hierarchy of controls, in orderState differences that matter in 2026Common SWMS mistakes to avoidFrequently asked questions
The starting point

When do you legally need a SWMS?

A SWMS is required only for high risk construction work.

A Safe Work Method Statement is legally required only for high risk construction work, and it must exist before that work starts. Regulation 291 of the model WHS Regulations lists 18 categories of high risk construction work, and Victoria lists 19 under its own OHS Regulations 2017. If at least one category applies to your job, you need a SWMS. If none apply, a SWMS is not legally required, though the general duty to manage risk still is.

This is the gate that decides everything else. The 18 model categories cover the work that kills and maims people most often: any risk of a fall of more than 2 metres, work on or near energised electrical installations, work in or near a trench or shaft deeper than 1.5 metres, demolition of load-bearing structure, work near mobile plant, asbestos, confined spaces, and more. Victoria splits trench and tunnel work into two separate categories and covers any demolition rather than only load-bearing demolition, which is why its list runs to 19.

Why does it matter enough to get right? Construction was Australia’s third-deadliest industry in 2024, with 37 worker deaths, one in five of all workplace deaths that year, according to Safe Work Australia. The same body reports that construction accounts for roughly 45% of all falls-from-height worker deaths. Regulators enforce it hard. In a single 2025 operation, SafeWork NSW issued 506 non-compliance notices, 192 of them for work at heights, and WorkSafe Victoria fined 52 employers a combined $3.74 million for working-at-height breaches in 2025 alone.

Australian carpenter working at height on the top plate of a timber-framed house with perimeter edge protection and scaffolding in place, the fall risk that triggers a SWMS

This is general information

This guide is general information for the Australian construction industry, not professional safety or legal advice. A SWMS must be made site-specific and prepared in consultation with the workers doing the work. If you are unsure, contact your state or territory WHS regulator or a qualified WHS professional. Read the model framework at Safe Work Australia.

The four elements

What must a SWMS include?

Four content elements under regulation 299, plus a fall rule.

Under regulation 299(2) of the model WHS Regulations, a SWMS must do four things: identify the high risk construction work; state the hazards and the risks each one creates; describe the control measures; and describe how those control measures are implemented, monitored and reviewed. It must be set out in a way that is readily accessible and understandable to the people who use it (regulation 299(3)).

A risk score or matrix is not one of the four elements. The law wants concrete controls, not a colour-coded number. The four elements are what an inspector reads against, so write them plainly for each task step.

  • Identify the high risk construction work the SWMS covers (reg 299(2)(a)).
  • State the hazards and the risks each one creates (reg 299(2)(b)).
  • Describe the control measures, listed in hierarchy-of-controls order (reg 299(2)(c)).
  • Describe how the controls are implemented, monitored and reviewed (reg 299(2)(d)).
  • For fall work over 2 metres relying only on admin or PPE, record every higher-order control you considered (reg 299(4)).

That fifth line is the one almost no template covers. Regulation 299(4) says that where a SWMS deals with a risk of falling more than 2 metres and relies only on administrative controls or PPE, it must also describe the higher-order controls that were considered. In plain terms: if you are going to work at height on a harness alone, you have to show you thought about edge protection or a scaffold first. You can start your SWMS draft in the free tool and fill these elements in for your own trade.

The four things a SWMS must contain

Reg 299(2)

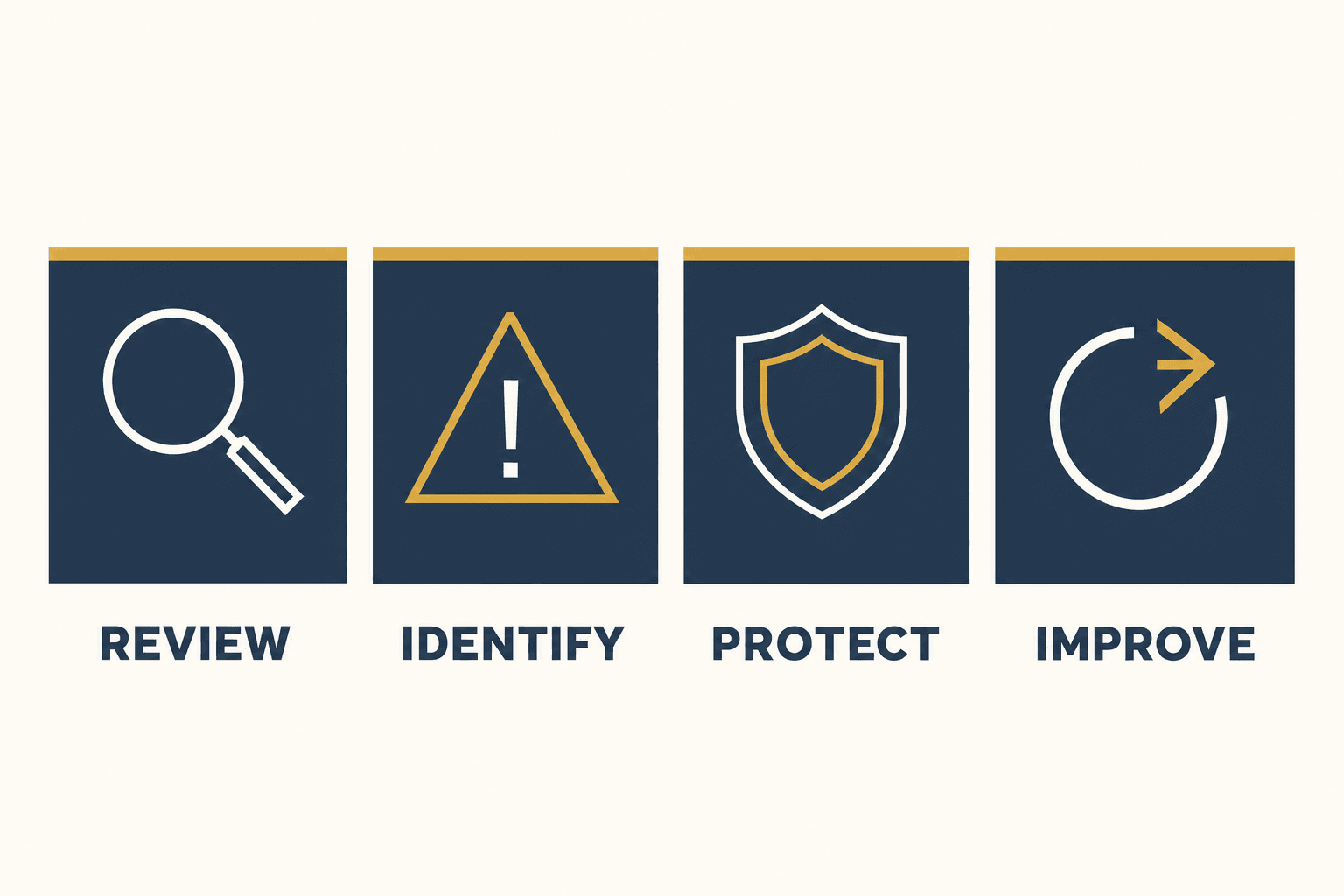

Diagram of the four content elements a SWMS must contain: identify the work, state hazards and risks, describe controls, describe monitoring and review

Read it as a checklist

  • Identify: name the high risk construction work.
  • Hazards and risks: the hazard and the harm it can cause.
  • Controls: in hierarchy order, eliminate first.
  • Monitor and review: who checks, when, and the stop rule.
The method

How to write a SWMS in seven steps

A repeatable sequence that mirrors the free tool’s wizard.

To write a SWMS, work through seven steps in order: enter your business and project details; identify which high risk construction work applies; break the job into task steps; list the hazards and risks for each step; choose controls in hierarchy-of-controls order; set out how the controls are monitored and reviewed; then consult your workers and complete the sign-on. These seven steps are the same steps our free SWMS generator walks you through.

Follow them in sequence and the four regulation 299 elements fall out naturally. Our free tool turns these seven steps into an editable starting document for your trade, so you are editing a draft rather than staring at a blank page.

The seven steps of a SWMS

1
▼

Project and site details

Record your jurisdiction, business, the site address, the work description and who prepared it. Forcing site-specific notes from the first field is what stops a SWMS being generic.

2
▼

Identify the high risk construction work

Check the job against the 18 model categories (reg 291), or Victoria’s 19, and name each one that applies. This is the legal gate for the whole document.

3
▼

Break the job into task steps

List the real steps in the order you will actually do the work, for example set-out, edge protection, install, detailing.

4
▼

List hazards and risks per step

For each step, state the hazard and the harm it can cause. Keep it specific to this site and this task.

5
▼

Choose controls in hierarchy order

Eliminate first (reg 35), then substitute, isolate or engineer, then administrative controls, then PPE last (reg 36).

6
▼

Set out monitoring and review

Describe who checks each control and when, and note the review triggers in reg 38(2). Add the stop rule for when work stops.

7

Consult workers and sign on

Walk the crew through the SWMS before work starts, capture the discussion, and record the sign-on. Signing is not the same as consulting.

The best way to see how this works is to map a real job to the four regulation 299 elements. Take roof truss installation, where the trigger is a fall of more than 2 metres from the top plate. The table below is that job written the way the law wants it. You can build a site-specific first draft with the free SWMS generator and shape it around your own build.

Worked example: roof truss installation, mapped to reg 299(2)

Reg 299(2) elementWhat it meansRoof truss install example
(a) Identify the HRCWName the high risk workWorking where a person could fall more than 2 metres from the top plate
(b) Hazards and risksThe hazard and the harmFall from height (death or serious injury); trusses collapsing before permanent bracing (crush); a craned truss swinging or dropping
(c) Control measuresControls in hierarchy orderPrefabricate bracing at ground level; edge protection or scaffold before install; fix each truss progressively with temporary ties; barricade the drop zone; harness to a rated anchor as a last resort
(d) Implement, monitor, reviewWho checks, when, the stop ruleSupervisor inspects edge protection and bracing before roof work each day and after wind; work stops if edge protection is incomplete

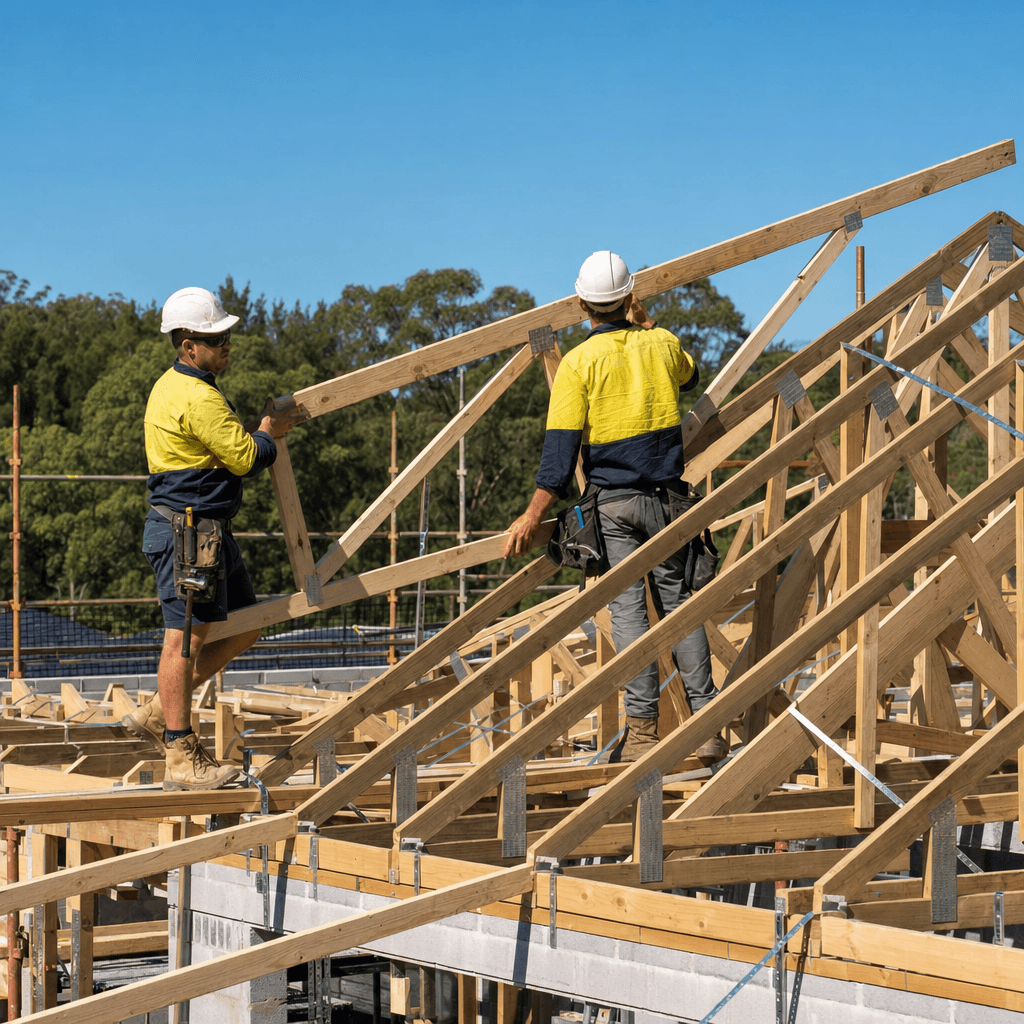

Two Australian carpenters installing roof trusses with temporary bracing and perimeter edge protection, a worked example of high risk construction work needing a SWMS
💡

Keep controls specific, not vague

“Use appropriate PPE” is not a control. It leaves the decision to the worker on the day, which is exactly what the Safe Work Australia Code of Practice and regulators reject. Name the control: which edge protection, which anchor rating, which exclusion zone. Specific and short beats long and vague.
Step 5, in detail

What is the hierarchy of controls?

The order the law makes you work through, eliminate first, PPE last.

The hierarchy of controls is the order you must work through when choosing controls for a SWMS. Eliminate the hazard entirely first (regulation 35). If elimination is not reasonably practicable, minimise the risk by substitution, isolation or engineering controls, then administrative controls, then personal protective equipment as the last resort (regulation 36). The SWMS must list controls in that order, not lead with the hard hat.

PPE last does not mean PPE never. It means PPE is the bottom layer, used once you have removed or reduced the hazard as far as you reasonably can with the higher-order controls above it. Work down these four tiers for every hazard you listed in step 4.

  1. Eliminate (reg 35). Remove the hazard entirely. Prefabricate at ground level, or re-sequence the work so nobody is exposed.
  2. Substitute, isolate or engineer (reg 36). Edge protection, scaffolds, trench shields, machine guarding, a physical barrier between the worker and the hazard.
  3. Administrative controls. Exclusion zones, spotters, a safe work sequence, permits, training and supervision.
  4. Personal protective equipment. Harness, hard hat, hi-vis, safety glasses, boots. The last line, never the first.

Eliminate first, PPE last

Reg 35 & 36

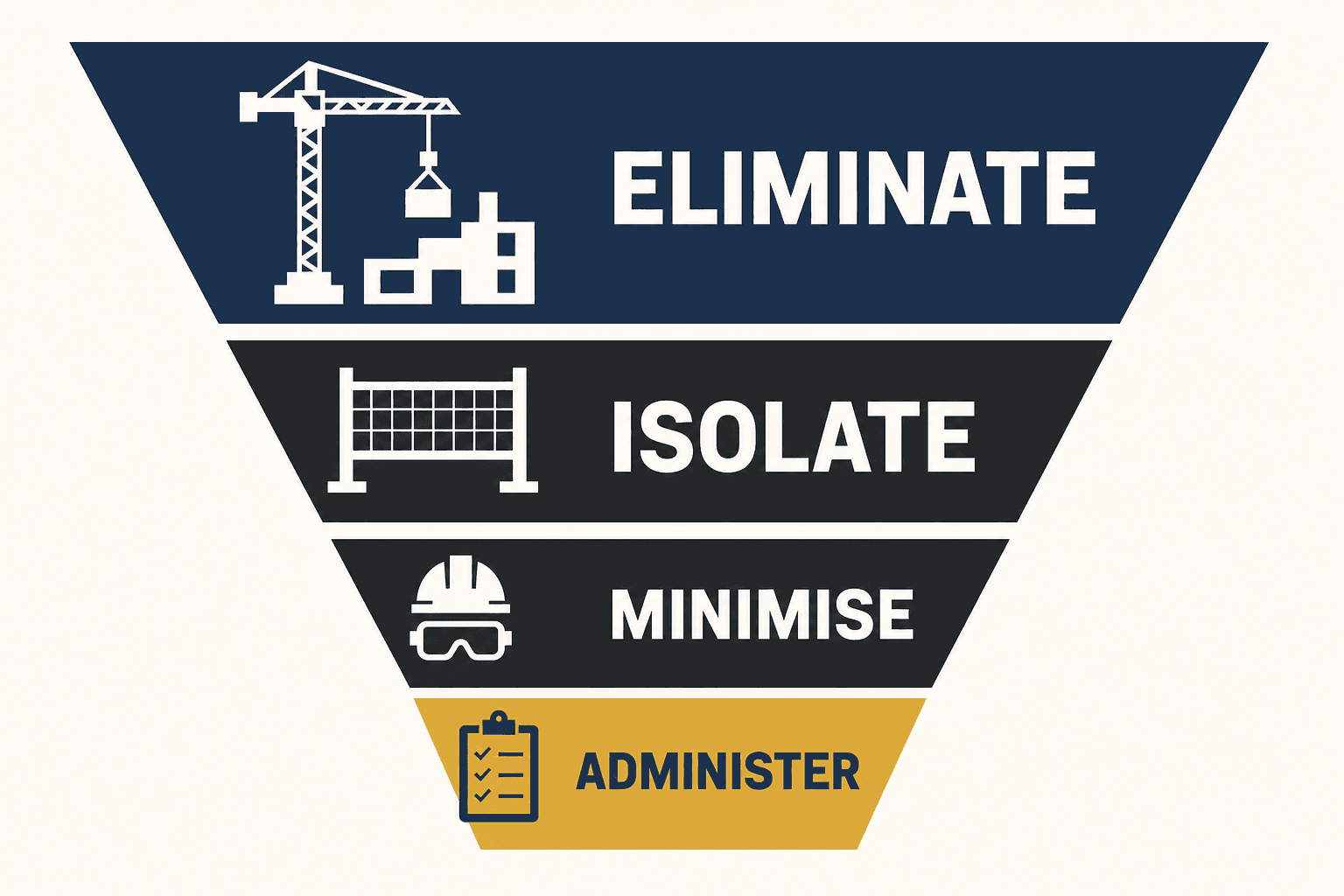

Hierarchy-of-controls funnel from Eliminate at the widest top through engineering and administrative controls down to PPE at the narrow bottom

Why the order matters

  • Higher-order controls protect everyone, not just the worker wearing the gear.
  • They do not rely on a person remembering to do the right thing every time.
  • PPE fails quietly, so it sits last, backing up the controls above it.

Trench work shows the hierarchy at its clearest. A trench deeper than 1.5 metres is high risk construction work on depth alone (reg 291). You cannot fix a collapse with a hard hat, so the real controls are higher-order: confirm services with Dial Before You Dig and hand-potholing, then shield or batter the walls, keep spoil back from the edge, and control the plant around it. Once you have your trade’s draft, you can generate a draft for your trade, then adjust it on site with your crew.

Trench work: controls in order

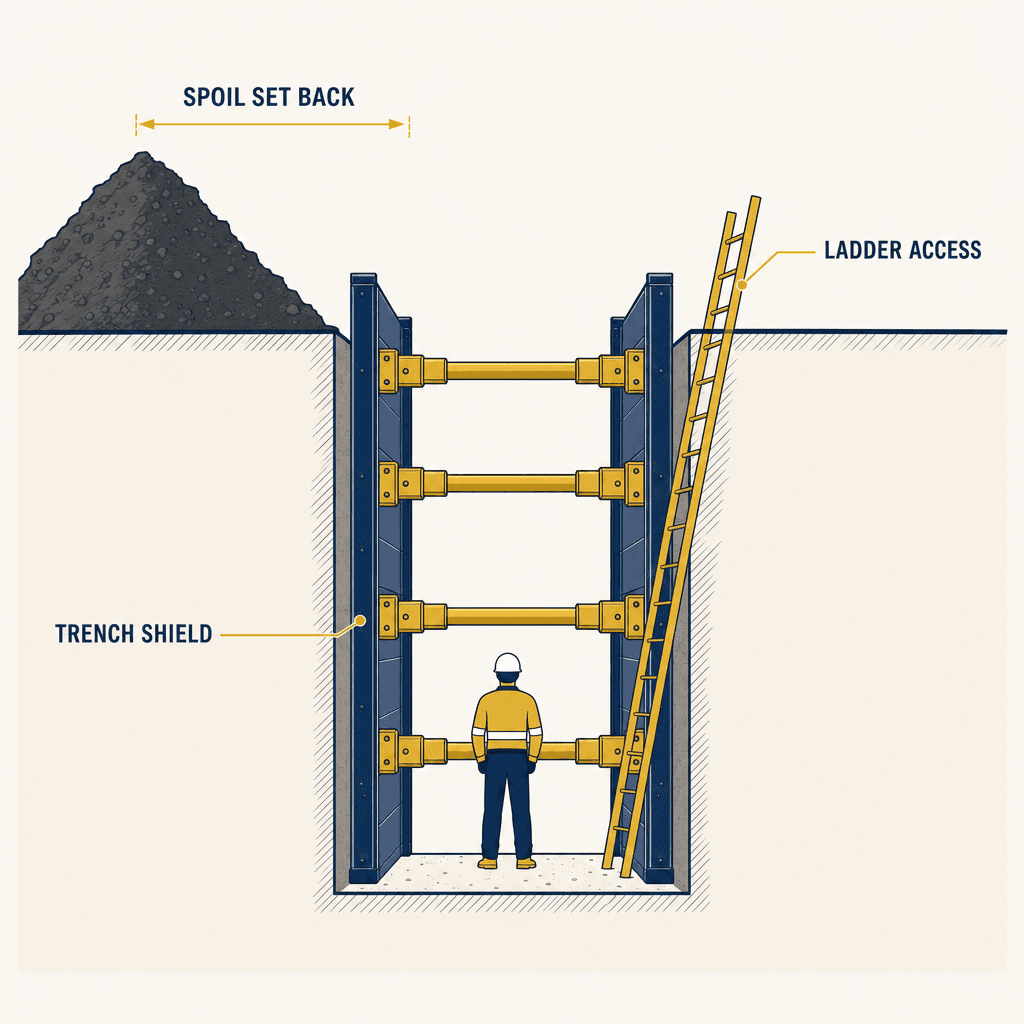

Worked example
Cross-section reference illustration of a shored construction trench with shield panels, ladder access and spoil set back from the edge

The quantified controls

  • Eliminate: Dial Before You Dig plans and hand-potholing before mechanical digging.
  • Engineer: trench shields or shoring rated to the soil for any excavation of 1.5 metres or more, so no one is in an unsupported trench.
  • Administrative: keep spoil at least 0.9 metres back from the edge; two ladder access points for any trench section longer than 8 metres; a spotter for plant near the edge.
  • PPE: hard hat, hi-vis and boots for everyone in or at the edge.
2026 currency

What state differences matter in 2026?

Victoria runs its own regime, and 2 metres is now national.

Most of Australia runs the model WHS Regulations, but three differences matter when you write a SWMS in 2026. Victoria runs its own OHS Regulations 2017 with 19 high risk construction work categories and puts the duty on the employer or self-employed person rather than a PCBU. New South Wales now sits under the WHS Regulation 2025. And from 1 July 2026 South Australia lowered its fall trigger to 2 metres, so 2 metres is now the fall-height trigger everywhere.

The table below is the state-by-state comparison no template seller puts in one place. Note that the principal-contractor project threshold is $250,000 under the model law and $350,000 in Victoria. If you work across borders, try the free, no-signup SWMS tool to get a first draft down and switch the jurisdiction to match the site.

SWMS rules by jurisdiction (2026)

JurisdictionInstrumentHRCW categoriesFall triggerDuty holder
NSWWHS Regulation 2025182 mPCBU
QldWHS Regulation 2011182 mPCBU
VictoriaOHS Regulations 2017192 mEmployer or self-employed person
South AustraliaWHS Regulations 2012182 m (from 1 Jul 2026)PCBU
WA, Tas, ACT, NTWHS Regulations (model)182 mPCBU

Penalties for having no SWMS before high risk construction work vary by jurisdiction, so the durable figure to quote is penalty units, not a single national dollar amount. The table below shows how the same breach converts differently by state.

No-SWMS penalty by jurisdiction

JurisdictionPenalty for no SWMS before HRCW
Model states (e.g. Qld)60 penalty units (about $10,362 in Qld as at 1 July 2026)
Victoria60 penalty units for an individual, 300 for a body corporate
ACTUp to $6,000 for an individual, $30,000 for a body corporate

One country, small but real differences

State by state

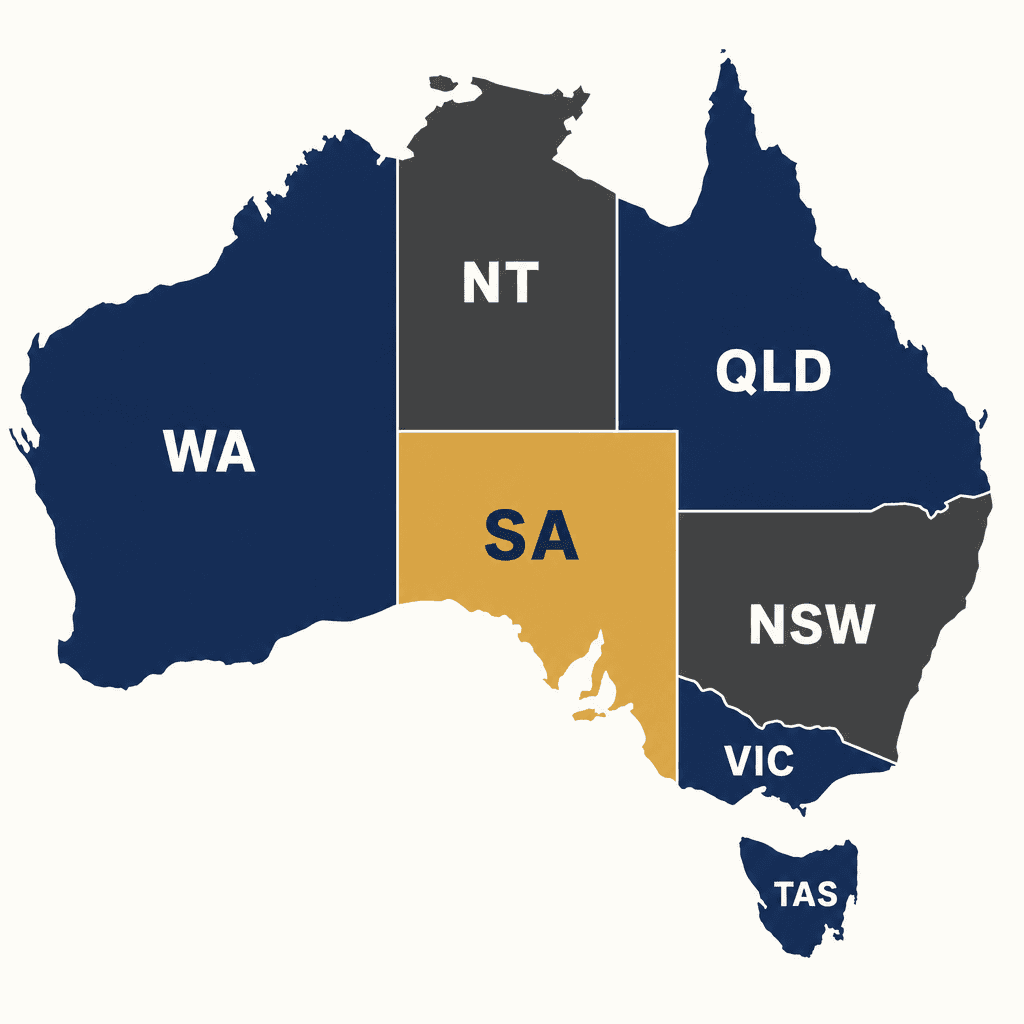

Stylised flat map of Australia divided into states and territories with South Australia highlighted, illustrating that SWMS rules vary by jurisdiction

What actually changes

  • Victoria: 19 categories, and the duty sits with the employer or self-employed person.
  • NSW: now under the WHS Regulation 2025, with SWMS provisions unchanged.
  • South Australia: 2 metres from 1 July 2026, the last state to move off 3 metres.
  • Project threshold: $250,000 model, $350,000 in Victoria.
Recent changes

What changed in 2025 and 2026

Nov 2024
Model Code of Practice: Construction Work
Safe Work Australia refreshed the benchmark for SWMS quality and construction risk management.
Jul 2025
SafeWork NSW blitz
506 non-compliance notices in one operation, 61 of them prohibition notices, 192 for work at heights.
Sep 2025
NSW WHS Regulation 2025
NSW remade its regulation. The SWMS provisions carried over unchanged, but the current instrument is now the 2025 regulation.
Jan 2026
WorkSafe Victoria enforcement
$3.74 million in fines across 52 employers for working-at-height breaches, almost exclusively construction.
1 Jul 2026
South Australia moves to 2 metres
SA lowered its fall trigger from 3 metres to 2 metres, making 2 metres the SWMS fall trigger in every jurisdiction for the first time.

Sources: SafeWork SA, WorkSafe Victoria, and SafeWork NSW.

What regulators flag

What are the common SWMS mistakes?

Generic and vague are the two that fail most.

The most common SWMS failure regulators flag is a generic, non-site-specific document used unedited across every job. The second is vague controls such as “use appropriate PPE” that leave the decision to the worker on the day. A third, less obvious one is an overly long SWMS: a lengthy, padded document is harder to understand, apply, monitor and review than a short, specific one.

“Generic SWMS often fail because they do not cater to the specific needs and conditions of a particular job site. Workers are less likely to follow a SWMS that feels irrelevant to their specific situation, reducing its effectiveness.”
Jay Powell, Principal, Powell Consulting (Diploma in Work Health & Safety, certified ISO 45001 auditor, 20+ years in WHS).
Australian site supervisor frowning at a thick generic paper document on a clipboard at the tailgate of a ute, the generic template that fails on site
⚠️

Signing is not the same as consulting

Handing a finished SWMS to the crew to sign is not genuine consultation. SafeWork NSW states that a PCBU must consult workers when they are likely to be, or are, directly affected by a health and safety matter, and that consultation must be regular and ongoing. Inspectors ask workers what they were briefed on, not just whether they signed. Walk the crew through the actual document before the work starts, and record the discussion.

  • A generic template used unedited, with nothing specific to the site.
  • Vague controls that require an on-the-spot decision, like “use appropriate PPE”.
  • An overly long, padded SWMS that no one can actually follow.
  • No review when conditions change, and no stop-work when the work does not match the SWMS.
  • A risk matrix in place of concrete controls, which the law does not ask for.

None of this means the paperwork has to be painful. You can get a head start on the paperwork with the free draft generator, no account needed and nothing you enter is uploaded or stored, the draft stays in your own browser. It is a starting point you make site-specific and consult your workers on before any work begins, not a finished document.

Who trains the people who write these

Build the skills behind the safety systems

An RTO that trains site supervisors and builders, not a template seller.

Prepare Training is a registered training organisation, RTO 45384, delivering nationally recognised building and construction qualifications online. The people who own site safety systems, the supervisors and builders who prepare and review SWMS, build those skills through construction qualifications, which is why this guide is written by an RTO rather than a template seller.

If you run high risk construction work and want the qualifications behind it, the Certificate IV in Building and Construction (CPC40120) covers site supervision and the WHS units, the Diploma of Building and Construction (CPC50220) steps up to construction management and larger-project safety systems, and the Advanced Diploma of Building and Construction (CPC60220) is the senior-management pathway. If you already run sites, Recognition of Prior Learning can turn that experience into a qualification, or browse all building and construction courses.

Not sure which one fits where you want to end up? Our guide to building and construction qualifications by state maps each one to the builder licence it unlocks in every state and territory.

FAQ

Frequently asked questions

Straight answers to the questions tradies ask most about writing a SWMS.

Blake Florimo, CEO of Prepare TrainingBF
Blake Florimo

Chief Executive Officer, Prepare Training

Blake Florimo is CEO of Prepare Training, RTO 45384. He writes about building and construction qualifications, RPL pathways, licensing context, and career progression for Australian tradies and construction professionals.

Relevant Qualifications

Courses for This Pathway

These nationally recognised qualifications meet the licensing requirements discussed in this guide.

Certificate IV in Building and Construction
QLDVICSATASNTACT
Building

Certificate IV in Building and Construction

CPC40120 - CPC40120 - Your pathway to becoming a licensed low-rise builder. Nationally recognised qualification for builders, site supervisors, and construction managers.

6-12 MonthsView Details
Diploma of Building and Construction
QLDVICSATASNTACT
Building

Diploma of Building and Construction

CPC50220 - CPC50220 - Your pathway to a medium-rise builder's licence. Nationally recognised qualification for builders, site managers, and construction professionals across QLD, VIC, SA, TAS, NT, and ACT.

12-18 MonthsView Details
Advanced Diploma of Building and Construction
QLDNSWVICSAWATASNTACT
Building

Advanced Diploma of Building and Construction

CPC60220 - CPC60220 - The pinnacle qualification for unlimited builder licensing. Manage high-rise, commercial, and complex construction projects of any scale across Australia.

12-18 MonthsView Details
More Licensing Guides

Explore Other States

Each state has unique builder licensing requirements. Explore our other guides to compare.

Site Surveys & Set-Out Guide
Building Skills5 Feb 2026

Site Surveys & Set-Out Guide

Master site surveys and set-out procedures for Australian construction—levelling techniques, the two peg test, contour plans, cut and fill calculations, and accuracy standards that ensure your buildings are positioned correctly.

Read Article
How to Read Construction Plans
Building Skills27 Jan 2026

How to Read Construction Plans

Master the essential skill of reading construction plans. Everything from site plans to structural details explained in this comprehensive guide.

Read Article
How to Start a Tradie Business
Career Advice11 Mar 2026

How to Start a Tradie Business

Everything you need to start a tradie business in Australia — from ABN registration and insurance to pricing strategies, finding clients, and growing from sole operator to building company. Construction-specific regulatory expertise from RTO 45384.

Read Article
RPL for Building & Construction
RPL & Qualifications26 Feb 2026

RPL for Building & Construction

The complete 2026 guide to Recognition of Prior Learning for construction professionals — step-by-step process, evidence requirements, costs from $500, 4-8 week timeframes, all 8 states accept RPL qualifications, and why 770,000 construction workers could benefit from RPL.

Read Article
Building Qualifications by State
QLDNSWVICSAWATASACTNT
RPL and Qualifications9 Jun 2026

Building Qualifications by State

One national guide that holds the three CPC building and construction qualifications constant and overlays the builder licence each unlocks in all eight states and territories. Covers the study-first and RPL routes, the experience years by state, and the two places the rule of thumb breaks (Victoria and the NT).

Read Article
GET IN TOUCH

Want the qualification behind the paperwork?

If you run high risk construction work and are weighing up a Certificate IV, Diploma or RPL pathway, speak to an advisor for honest, no-obligation advice on the right fit for your trade.
