Prepare Training

Nationally recognised building and construction qualifications delivered 100% online.

RTO 45384

Qualifications

BuildingCertificate IV in BuildingCertificate IV NSW/WADiploma of BuildingDiploma of Building NSW/WAAdvanced DiplomaWork Health & SafetyCertificate IV in WHSDiploma of WHSProject SupportEstimatorContract AdministratorSupervisionLow-Rise Site SupervisorOpen Class Site SupervisorView All Courses

Resources

BlogLicence GuidesTools & CalculatorsRecognition of Prior LearningCourse ComparisonFAQs

Get in Touch

1300 142 181hello@prepare.com.au
15/1 Newspaper Pl
Maroochydore QLD 4558
Enquire Now

© 2026 Prepare Training. RTO 45384. All rights reserved.

Privacy PolicyTerms of Service
Builder reviewing construction cost estimate documents and plans at a residential building site
Building Skills

Construction Cost Estimation

The complete guide to estimating construction costs in Australia. Learn quantity takeoff methods, current building costs per square metre, how to build unit rates, and the overhead and profit margins that keep your business sustainable.

View Current CostsQuantity Takeoff Guide
  1. Home
  2. Blog
  3. Construction Cost Estimation Guide
~5%
Avg Profit Margin
30.8%
Above Pre-COVID Costs
5.3%
2025 Cost Escalation
$99k
Avg Estimator Salary

In This Guide

  1. What is Construction Cost Estimation?
  2. Types of Estimates
  3. How to Do a Quantity Takeoff
  4. Current Building Costs (2025-2026)
  5. Building Up Unit Rates
  6. Material Waste Allowances
  7. Overhead, Profit & Contingency
  8. Cost Escalation Forecast
  9. Estimating Software
  10. Common Mistakes to Avoid
  11. Career Pathways
  12. Frequently Asked Questions
The Fundamentals

What is Construction Cost Estimation?

Construction cost estimation is the process of forecasting the total cost of a building or construction project. It involves measuring quantities from drawings, applying prices for materials and labour, and adding appropriate allowances for overhead, profit, and risk.

Accurate estimation is fundamental to construction success — it determines project viability, enables competitive tendering, and provides the baseline for budget control throughout the project.

Why Estimation Matters

  • Determines if a project is financially viable
  • Enables competitive bids that win work profitably
  • Provides baseline for tracking actual vs planned costs
  • Identifies cost risks early for mitigation
  • Builds client confidence and trust
  • Enables accurate cash flow planning

Competency Standards

In Australia, cost estimation is covered by national competency unit:

CPCCBC4004 — Identify and produce estimated costs for building and construction projects

This unit is part of the Certificate IV in Building and Construction.

Accuracy Levels

Types of Estimates and When to Use Them

Estimate accuracy improves as project design develops. Understanding which estimate type suits each project stage prevents both over-engineering early estimates and under-preparing for tenders.

Concept
-30% to +50%

Order of Magnitude

Rough budget for feasibility. Based on historical data and $/m² rates.

Schematic
-15% to +25%

Preliminary

Compare design options. Uses elemental cost analysis.

Design Development
-10% to +15%

Detailed

Refined budget with quantity takeoffs from developed drawings.

Tender
-5% to +10%

Definitive

Competitive pricing from complete documentation.

Construction
±5%

Control

Track actual costs. Manage variations and progress claims.

💡

Match Effort to Stage

Don't waste time preparing detailed estimates for concept-stage projects — the design will change. Conversely, never submit a tender based on $/m² rates alone. Match your estimation effort to the information available.

Core Skill

How to Do a Quantity Takeoff

Quantity takeoff is the process of measuring and listing all materials, labour, and resources needed for a project from construction drawings. It's the foundation of accurate cost estimation.

Quantity Takeoff Process

Step by Step

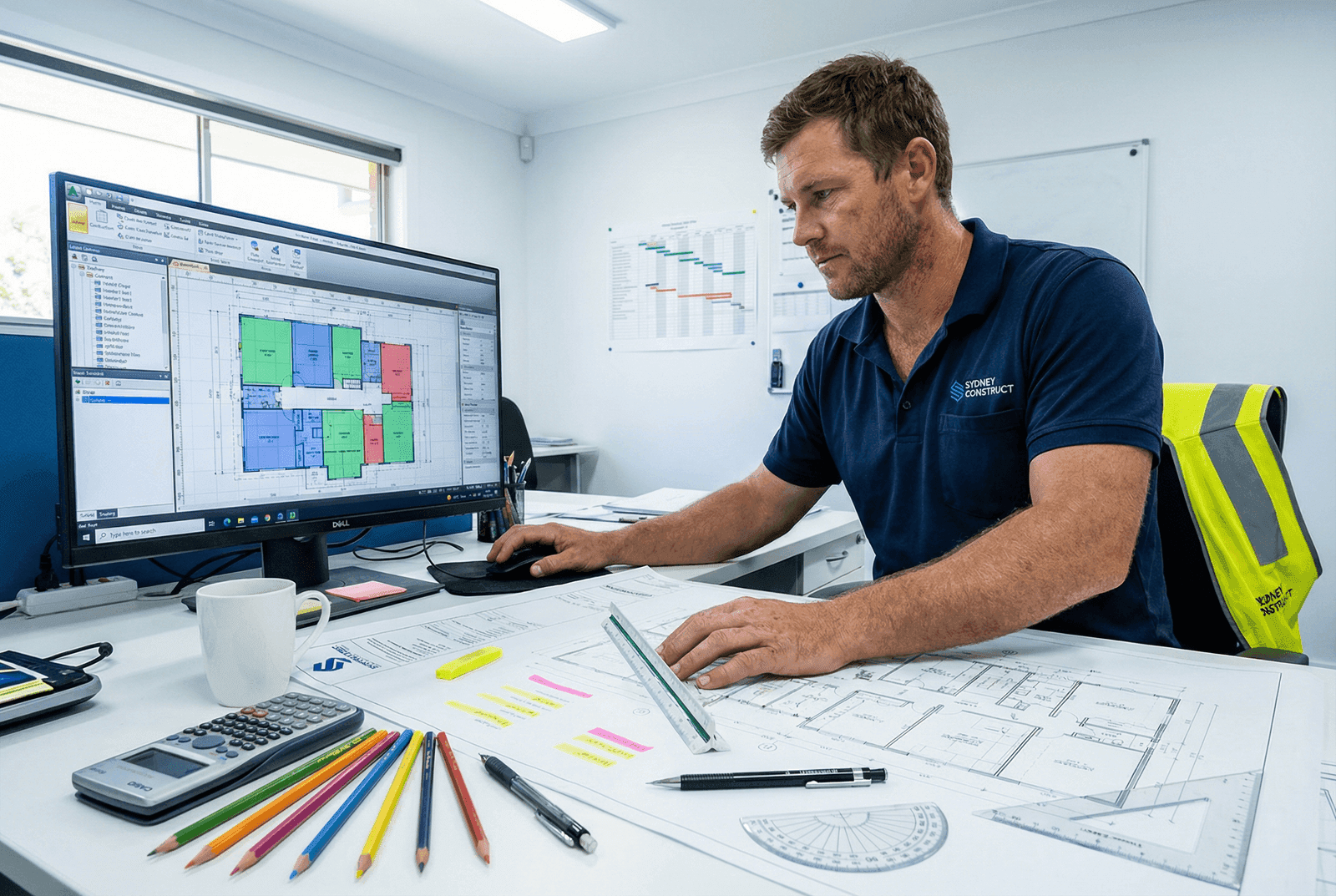

Construction estimator using digital takeoff software on monitor with coloured floor plan overlays, scale ruler, calculator and construction plans on desk

Manual vs Digital Takeoff

Manual: Using scale rulers, calculators, and coloured pencils on printed drawings. Time-intensive but develops fundamental understanding.

Digital: Import PDFs or CAD files into software like PlanSwift or Buildsoft. Click to measure areas, lengths, and volumes. Up to 10x faster for large projects.

01

Review All Drawings

Familiarise yourself with the full drawing set — plans, elevations, sections, details, and specifications.

02

Organise by Trade

Work systematically through each trade: excavation, concrete, framing, roofing, finishes, services, etc.

03

Measure Quantities

Record quantities using appropriate units: m² for areas, m for linear, m³ for volume, No. for items.

04

Add Waste Allowances

Apply appropriate waste factors (2-15% depending on material) to net quantities.

05

Apply Unit Rates

Multiply quantities by unit rates including labour, materials, and plant costs.

06

Check and Verify

Cross-check totals, verify against $/m² benchmarks, review for omissions.

2025-2026 Data

Current Building Costs in Australia

Construction costs are currently 30.8% above pre-COVID levels. These indicative rates help with preliminary budgeting — always obtain current quotes for specific projects.

Residential Construction ($/m²)

CityBasicMid-RangeHigh Spec
Sydney$1,630$3,500$6,010
Melbourne$1,620$3,100$4,720
Brisbane$1,570$2,400$3,310
Perth$1,360$2,200$3,000
Adelaide$1,430$2,400$3,410

Commercial Construction ($/m²)

Building TypeLow RangeHigh Range
Office Buildings$2,500$5,500
Retail Spaces$1,800$4,800
Industrial/Warehouse$1,300$3,800
Healthcare Facilities$3,000$6,500

Sources: Koste, Matrix Estimating, Rawlinsons (2025). Rates are indicative only and exclude land, professional fees, and external works.

Pricing Fundamentals

Building Up Unit Rates

A unit rate is the cost per standardised unit of measurement — per square metre, per linear metre, per item. Understanding how unit rates are built up helps you price accurately and identify where costs can be controlled.

Unit Rate = (Labour + Materials + Plant) × (1 + Overhead%) × (1 + Profit%)
Direct Costs

Labour

  • Base wages and on-costs
  • Super, WorkCover, leave provisions
  • Productivity allowances

Materials

  • Supply cost (inc. GST handling)
  • Delivery to site
  • Waste allowance

Plant & Equipment

  • Hire rates (wet or dry)
  • Operating costs (fuel, maintenance)
  • Mobilisation/demobilisation
Indirect Costs (Preliminaries)
  • Site establishment and offices
  • Site management and supervision
  • Temporary services (power, water, fencing)
  • Scaffolding and temporary works
  • Cleaning and rubbish removal
  • Insurance and bonds
  • Safety and compliance costs
  • Quality control and testing

Preliminaries typically run 10-15% of direct costs for residential, higher for commercial projects.

Material Factors

Standard Waste Allowances

Waste allowances account for material losses during transport, handling, cutting, and installation. Apply these percentages on top of net quantities from your takeoff.

MaterialWastage %
Cement2-5%
Sand5-12%
Concrete/Aggregate5-10%
Reinforcement Steel2-5%
Structural Steel10-15%
Bricks/Blocks2-5%
MaterialWastage %
Tiles4-10%
Plywood/Timber5-10%
Plasterboard5-10%
Stone10-15%
Paint2-5%
Insulation3-5%
💡

Track Your Own Data

These are industry averages — your actual waste rates depend on crew skill, design complexity, and material handling. Track ordered vs installed quantities on your projects to build accurate, project-specific waste factors.

Margins and Risk

Overhead, Profit, and Contingency

These additions transform a cost estimate into a sustainable price. Get them wrong and you'll either lose money on every job or lose jobs to competitors.

Overhead

Costs of running your business not charged to specific projects:

  • Office rent and administration
  • Vehicles and general equipment
  • Insurance, legal, accounting
  • Marketing and business development

Typically 8-15% of direct costs

Profit Margin

Your return on investment and reward for taking risk. Industry average is thin:

~5%
Industry average (Master Builders)

Many aim for 10-15%, but actual margins often end up lower due to variations, rework, and price increases.

Contingency

Allowance for unforeseen costs and risks. Decreases as design definition improves:

  • Early design: 25-30%
  • Developed design: 15-20%
  • Tender stage: 5-10%
  • Construction: 3-5%

Renovations typically need higher contingency than new builds.

⚠️

Profit Margin ≠ Mark-Up

A 10% mark-up does not equal a 10% profit margin. Mark-up is added to costs; margin is calculated from selling price. A 10% mark-up yields roughly 9% margin, and that's before any cost overruns eat into your returns.

Market Outlook

Cost Escalation Forecast (2025-2026)

Construction costs continue to rise, though at a slower pace than the 2022-2023 spike. For projects spanning multiple years, escalation allowances are essential.

City2025 Escalation2026 Forecast
Brisbane7.0%6.0%
Gold Coast6.5%5.5%
Perth5.5%5.0%
Melbourne5.0%4.5%
Sydney4.6%4.8%
Adelaide4.5%4.5%
Canberra3.0%3.5%

Source: WT Partnership Market Conditions Report (2025)

Key Cost Drivers

  • Energy costs: Electricity up 23.6% over past year, affecting cement, aluminium, and bricks
  • Labour: Trade wages rising 4-5% annually; productivity has halved since 1995
  • Materials: Concrete, bricks, and plasterboard rising; steel and diesel subdued
  • Outlook: Relief unlikely before 2028 according to industry analysts
Tools of the Trade

Estimating Software for Australian Builders

Digital estimation tools dramatically improve speed and accuracy. Here are the main options available in Australia.

From $170/month

PlanSwift

Used by 6,500+ Australian companies

  • Point-and-click takeoff from PDFs/CAD
  • Drag-and-drop assemblies with labour + materials
  • Excel integration
  • Local AU/NZ support
  • Learn in under 14 days
Contact for pricing

Buildsoft Cubit

Australian-made, 40+ years in industry

  • Intelligent single-click space takeoff
  • 3D visualisation
  • AI estimating features
  • Quote and tender management (Cubit Select)
  • Local development and support
Contact for pricing

CostX (iTWO)

Enterprise solution for larger projects

  • BIM integration and 5D modelling
  • Advanced revision comparison
  • Team collaboration features
  • Quantity surveyor focused
  • Higher learning curve
💡

Start with Spreadsheets

For smaller builders, spreadsheet-based systems using Excel with Rawlinsons Construction Cost Guide ($450/year) remain a cost-effective starting point. You can always upgrade to dedicated software as your business grows.

Quality Control

Common Estimation Mistakes to Avoid

These errors cost builders money and reputation. Recognising them helps you implement checking procedures and produce more reliable estimates.

Quantity Errors

  • Missing items: Forgetting to include obvious items like flashings, sealants, or fixings
  • Double counting: Measuring the same area twice when using different drawings
  • Scale errors: Reading wrong scale or not verifying scale on drawings
  • No waste allowance: Pricing net quantities without waste factors

Pricing Errors

  • Outdated rates: Using last year's prices in a 5%+ escalation market
  • Forgetting on-costs: Using base wages without super, WorkCover, leave
  • Ignoring site conditions: Standard rates for difficult access or remote sites
  • No escalation: Fixed pricing on long-duration projects

Margin Errors

  • Inadequate overhead: Not recovering true cost of running the business
  • Racing to the bottom: Cutting margin to win jobs, then losing money
  • No contingency: Zero allowance for unforeseen issues
  • Confusing mark-up and margin: Thinking 10% mark-up = 10% profit
⚠️

Check Before Submitting

Before submitting any estimate: verify totals against $/m² benchmarks, have another person review the takeoff, confirm all items from the specification are included, and check that overhead, profit, and contingency are appropriate for the risk.

Professional Development

Career Pathways: Becoming a Construction Estimator

Construction estimation is a valued skill that can lead to dedicated estimator roles or enhance your capabilities as a builder or project manager.

Estimator Career Overview

Industry Data
Construction estimator at desk with dual monitors showing spreadsheet and floor plans, Australian Construction Handbook and calculator on desk

Industry Statistics

  • ~7,000 estimators employed in Australia
  • $73k-$99k average salary range
  • 87% work full-time (avg 42 hrs/week)
  • Mining/resources pay highest ($135k avg)

Qualification Pathway

  • CPCCBC4004 — Core estimation competency
  • CPCBC40120 — Cert IV Building & Construction
  • Cert IV Building Project Support (Estimator) — Specialist estimation pathway
  • CPCBC50220 — Diploma for advanced roles
  • QS degree — For quantity surveying career

Estimator vs Quantity Surveyor

Estimators focus on pre-construction cost estimation, typically working for builders on residential and smaller commercial projects. Understanding estimation is also valuable for anyone pursuing a builder's licence.

Quantity Surveyors are degree-qualified professionals (often AIQS members) who manage costs throughout the entire project lifecycle. QS services cost 1-2% of project value but can prevent 10-30% budget overruns. Consider engaging a QS for projects over $1M.

Not sure which qualification suits your career goals? Compare qualifications or learn how to study while you work.

Common Questions

Frequently Asked Questions

Multiply the gross floor area of the building by the appropriate cost per square metre rate for your location and specification level. In 2025, residential costs range from $1,360/m² (basic, Perth) to $6,010/m² (high-spec, Sydney). Always add contingency (10-15%) and professional fees on top. These rates are indicative—obtain current quotes for your specific project.

Disclaimer: Construction costs vary significantly by location, project type, market conditions, and individual circumstances. The figures provided are indicative only and should not be relied upon for specific project decisions. Always obtain professional advice and current quotes for your specific project. For complex or high-value projects, engage a qualified quantity surveyor or professional estimator. Pricing data sourced from industry publications including Rawlinsons, AIQS, and WT Partnership (2025-2026).
